Overview
ODOT maintains the land adjoining highways and transportation infrastructure, or right of way. Part of that maintenance includes litter removal and graffiti cleanup. We do a lot of work to keep our roads clean, but the problem is constant and increasing at rates greater than our crews, volunteers and partners can keep up with.
In 2024, the Oregon Legislature passed Senate Bill 5701 giving ODOT $20 million in general fund dollars for litter removal, graffiti cleanup, camp cleanup and access prevention in the Portland metro area for use through June 2025. This funding was available on April 17, 2024 and on April 18, we had contracts in place for the work.
In addition, we are partnering with local business leaders to pilot a Sponsor-a-Highway program that is currently removing graffiti and litter on the I-405 corridor in Portland.
As of April 30, 2025, these efforts have accomplished the following:
| May 2025
| Outcomes to date
|
---|
Litter removal
| 21,220+ lbs. collected
| 265,640 lbs. collected
|
Graffiti removal
| 1,574+ tags removed
| 23,823+ tags removed
|
Camp clean-up
| 227 camps cleaned up
| 2,152 camps cleaned up*
|
Access prevention
| 8 projects underway, 10 projects are in construction or under contract
| 23 projects completed*
|
*April 2024 was first month of graffiti, camp cleanup & access prevention work with SB 5701 funds
Clean up locations in May 2025
|
|

Wall before graffiti removal.
|

Wall after graffiti removal.
|
Litter and graffiti removal happens along state highways in our Portland Metro Region (Multnomah, Clackamas and Washington counties).
In May, our primary litter removal focus areas were:
- I-205 between mile points 0 and 26 - throughout the corridor roughly between I-5 in the Tualatin area and the Sandy Blvd exit in NE Portland.
- U.S. 26 (Sunset Highway) between mile points 55 and 65 – throughout the corridor from Dersham Rd in Cornelius to Hillsboro.
- I-5 southbound between mile points 282 and 308 – roughly from SW Multnomah Blvd to Hayden Island.
- I-84 east and west between mile points 0 and 17, from I-5 to Troutdale.
- I-405 in downtown Portland

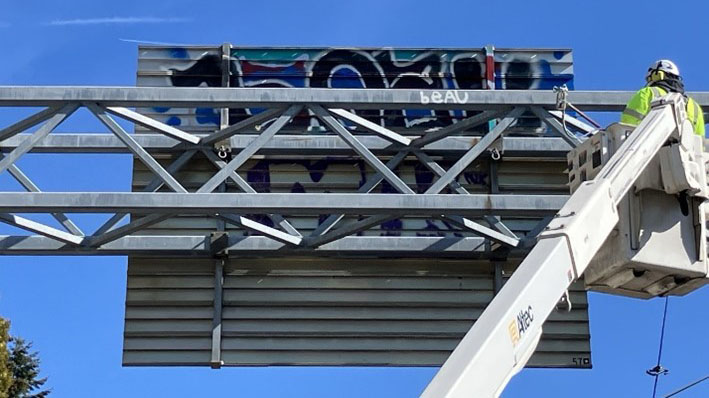

In May, our primary graffiti removal focus areas were:
- I-84
- I-205
- I-5
- US 26
- I-405
This work includes the removal of over 1,574 tag clusters. Graffiti was removed from 255 signs and 93 signs were replaced. Since April 2024, a total of 793 signs have been cleaned and 268 were replaced.
Camp cleanup was conducted at the following locations by city of Portland contractors:
- Frequent posting & cleaning areas:
- Major projects completed:
- I-5 NB from SW Bertha/Terwilliger
- 1-405 NB mainline beneath Glisan
- I-5/I-84 NB island beneath Morrison
Funding Spent to Date*
Numbers may not reflect all worked billed during this time period.
Funding from SB 5701
| Total Budget
| Spent to date
| Spent this month
| Remaining
|
---|
Litter removal
| $5 million
| $4,335,364
| $326,291
| $664,636
|
Graffiti removal
| $2.5 million
| $2,478,442
| $261,696
| $21,559
|
Camp clean-up
| $5.5 million
| $4,569,836
| $345,065
| $930,164
|
Access prevention
| $7 million
| $4,902,389
|
| $2,097,611
|
Total
| $20 million
| $16,286,030
| $933,052
| $3,714,970
|
