Overview
Implementation for Digital Accessibility Policies
ODHSOHA 010-029 and
ODHSOHA 010-030 will proceed according to the following timeline. During Phase 1, focus was systematically directed toward public-facing resources. During Phase 2, focus has shifted include some internal-facing resources.

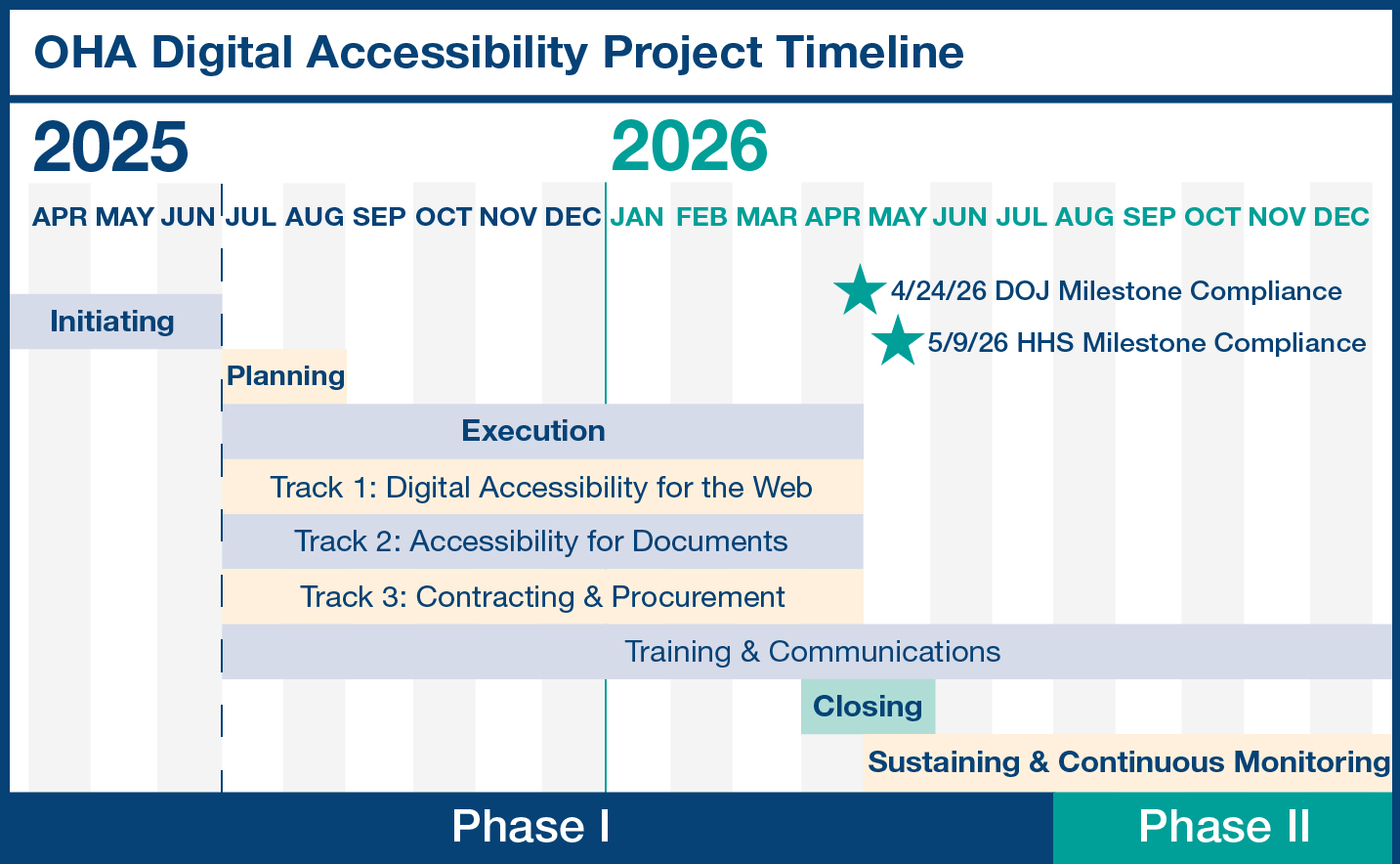

Project Timeline Description
Phase 1 (April, 2024 – July 2026)
- Initiating (April – June 2025)
- Planning (July – August 2025)
- Execution (July 2025 – Ongoing)
- Track 1: Digital Accessibility for the Web
- Track 2: Accessibility for Documents
- Track 3: Contracting & Procurement
- Training and Communications (July 2025 – Ongoing)
Key dates
- 4/24/26: DOJ Milestone Compliance
- 5/9/26: HHS Milestone Compliance
Phase 2 (August 2026 – April 2027)
- Execution (August 2026 – April 2027)
- Track 1: Digital Accessibility for the Web
- Track 2: Accessibility for Documents
- Track 3: Contracting & Procurement
- Training and Communications
- Closing (April 2027 – May 2027)
Key Deliverables / Processes
Digital Accessibility for Web
- Automated Testing with Siteimprove (Ongoing)
- Manual Testing (Ongoing): 100+ web pages tested during Phase 2
- Office hours for developers, designers and content authors (Ongoing)
Digital Accessibility for Documents
- Establishment of Division-level champion and leaders network (Spring, 2026)
- Working with PCS and Divisions to ensure new documents meet accessibility standards (Ongoing)
- Remediation of high-impact pre-existing documents (September 2025 - Ongoing)
Contracting and Procurement
- New contract language and contracting playbook (completed March 2026)
- Updating contract templates (ongoing)
- Roll out of materials for accessible procurement (December, 2026 - January, 2027)
Training and Communciations
Training
-
Accessibility for OIS Web Designers - "ADA Tasks" (published to the OWL September 2025)
- "Getting Started with Digital Accessibility" (published to Workday January 2026)
- Digital Accessibility Knowledge Base (published to OWL March 2026)
- "Creating Accessible Documents" (published to Workday April 2026)
- Web Accessibility Training and Assessment (Coming soon to Workday)
Maturity Assessments
